The Britannia project was a significant undertaking involving the removal and replacement of a 9,000 square foot gym floor within a strict 9 week schedule in which Robertson Floors was responsible for all aspects of the project from start to finish including the following scope of work:

  1. Remove and dispose of existing hardwood flooring, subfloor, sleepers, and shims
  2. Shotblast and grind substrate to make ready for self-leveling compound
  3. Supply and place over 1,100 bags of Mapei Novoplan 2 self-leveler (approx. ” average)
  4. Supply and install new subfloor system complete with sleepers and EPDM cushions
  5. Supply and install new Maple hardwood flooring
  6. Sand and finish hardwood flooring with 3 coats of moisture cured urethane finish complete with line painting and staining
  7. Supply and install new sockets, vent coved base, and thresholds

Britannia Secondary School & Community Centre
photos Ernest von Rosen (www.amgmedia.com)


july 3
Original Floor (approximately 60 years old, unlevel, and in need of replacement)


july 5
Demolition, Shotblasting, and Grinding


july 10
Pinned, Primed, and Sectioned off ready for Self-Leveler

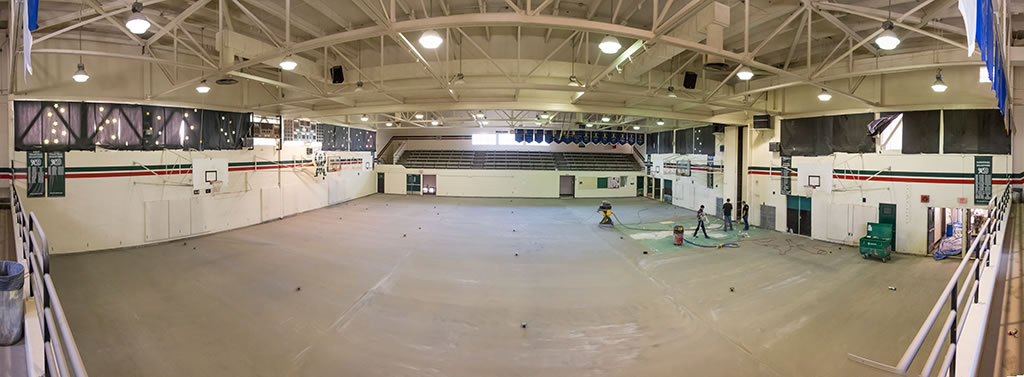

july 12
Post leveling (over 1,100 bags; approximately. ” average; max. 1/8” over 12’ tolerance)

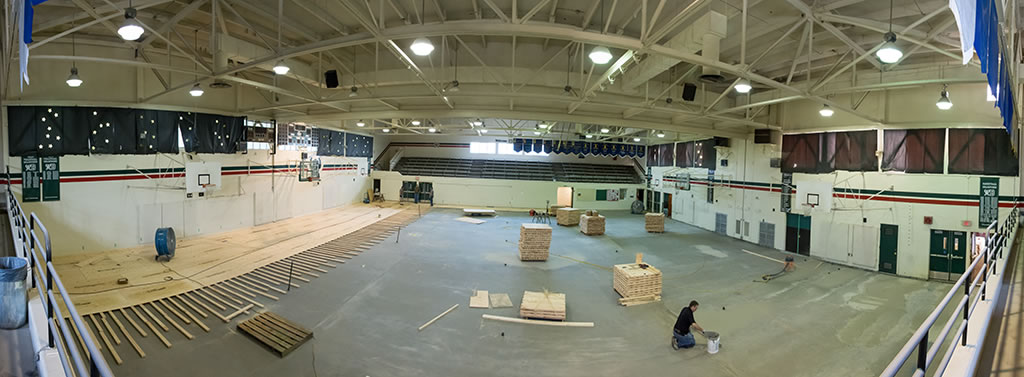

july 26
Subfloor System Installation (Cushions, Sleeper's, and Plywood)


aug 10
Hardwood Installation


aug 16
Sanding

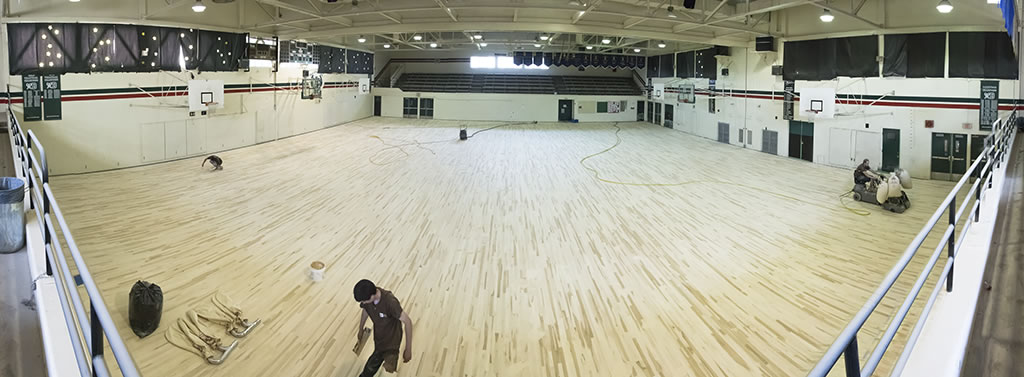

aug 17
Sanding (Continued)


aug 23
Staining & Sealer Coat


aug 30
Line Paint, Logos, and Second Coat of Finish


sept 14
New Floor in Use with Final Top Coat and Sockets Installed
